Working in a Team

Working in a Team

Objectives

Assess project feasibility
  • Estimation
  • Scheduling
  • Risk
  • Should you commit to a project?
    • Before committing, conduct a study to inform a go/no-go decision
    • Result may be a proposal or lead to a budget request
Produce a project plan
  • A detailed project plan is critical

Feasibility studies are difficult

Must grapple with uncertainty
  • Unclear scope
  • Uncertain or hard-to-quantify benefits
  • Rough estimates of resource requirements and timetable
  • Technical approach may not pan out
  • Organizational changes may be required
  • Opportunity costs
Rely on judgement of experienced people
  • Early mistakes are the most costly
    • Need to advocate to build support
  • But beware risk distortion, ulterior motives
    • Example: US government agency
Discussion
  • Designate one person as a note taker/final reporter
  • Which methodology is most appropriate for a large, complex project with incomplete requirements?

Things to consider in a feasibility study

Overview
  • Scope
  • Approach
  • Methodology
  • Resources
  • Schedule
  • Risks
  • Alternatives
Scope clarification
  • Define the boundaries of the system
    • List of included features
    • List of excluded features
    • List of dependencies
    • List of current systems being replaced
  • Confusion over scope often leads to client dissatisfaction
  • Should also review existing systems (including competitors’)
Technical approach
  • Proposed system must be technically feasible
    • Estimates of scale (number of users, volume of data, rate of transactions)
    • Identify features that require research (no standard solution) or new team expertise (domain-specific knowledge, advanced techniques)
  • Analyze a viable design to estimate resources, schedule
    • Tentative system architecture (data storage, UI context, deployment infra)
  • Approach used by final product may be very different
Estimation
  • Essential skill for efficient planning
Discussion
  • Designate one person as a note taker/final reporter
  • Fermi problems:
    • Tips: first identify dimensions of answer (dimensional analysis)
    • What is the sustained half-duplex bandwidth between Ithaca and NY Tech of a UPS truck full of hard drives?
    • How many Raspberry Pi computers would be required to serve as a distributed cache for a global reverse phone book?
Estimation for scheduling
  • Estimating task duration is very difficult, but can be improved with feedback
    • Estimate effort of task before starting
    • Keep a log of time spent on each task (design, documentation, implementation, testing, review)
    • Compare log to estimate when closing out tasks
    • Keep a log of time spent on other aspects of project (meetings, training, reports, reviews)
  • Do not evaluate effort until task is 100% complete
    • Large gap between “almost done” and “done”
    • Documentation
    • Tests
    • Cleanup
    • Review
  • Beware Parkinson’s Law: “Work expands to fill the time available”
    • Don’t neglect startup time
Agile velocity
  • Dartmouth example: projects consistently took 30-40% longer even when requirements were well understood.
    • Additional tasks discovered
    • Some tasks must be iterated
    • Personnel have other commitments
    • Schedule conflicts
  • Decouple effort from time
    • Estimate effort required for task in relative units (e.g. “story points”)
    • Tally the effort units completed by the whole team in one sprint: velocity
    • Use velocity to select appropriate number of tasks for future sprints; forecast milestones accordingly

Milestones and deliverables

Deliverable
  • Work product provided to the client
    • Mock-up
    • Demonstration
    • Prototype
    • Report
    • Presentation
    • Documentation
    • Code
  • Release of a system or subsystem to customers and users
Milestone
  • Completion of a predetermined set of activities
    • Delivery of a deliverable
    • Completion of a process step
    • End of a sprint
    • Reaching a testing target
  • An internal goalpost, useful for monitoring progress against the schedule
    • Provides visibility

Initial preparation steps

Outline plan
  • Your first report requires an outline plan
    • Preliminary timetable
    • Process steps (or sprints)
    • Milestones (including deliverables)
    • Decision points
    • Interactions with and dependencies on external parties
  • Plan should be reviewed, refined, revised regularly
Scheduling activities
  • Inputs:
    • Duration
    • Dependencies
    • Resources
Activity networks

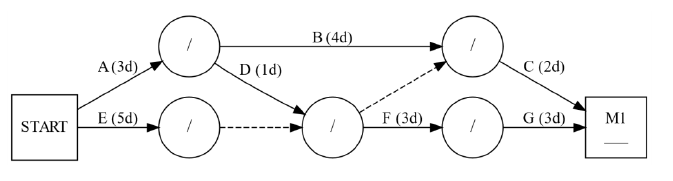

  • Critical path analysis
  • Gannt charts
    • In combination with milestones
Risk management
  • Identify risks
    • Brainstorm what could go wrong
  • Analyze risks
    • Determine likelihood and consequence
    • Prioritize based on “risk”
  • Plan
    • Avoidance: reduce likelihood
    • Mitigation: reduce consequence
    • Contingency: “Plan B”
  • Monitor
    • Update risks regularly
  • Feasibility studies and project plans should be written
    • Well-written, well-presented – review entire document
    • Short enough that everybody reads it
    • Long enough that no important topics are skipped
    • A report that is not read and understood is not useful
  • Keep in mind:
    • Team availability, team skills
    • Time constraints
    • Equipment and software
    • Start-up time = Client availability
    • Scope (not vague, not too ambitious)
